Project Update - October

BSC - Sewering Coastal Villages Project - November Update 160dpi.jpg

Bellingen Shire Council’s major sewer expansion project is progressing well across Raleigh, Yellow Rock, and Mylestom. The works include the construction of sewer rising mains and new pump stations, as well as the installation of 226 pressure sewer systems at residential and commercial properties. Once complete, these upgrades will provide modern, reliable wastewater services for the coastal communities.

Construction of the sewer rising mains along Giinagay Way, Yellow Rock Road, and the connection to Norco is now complete, with pressure testing at Raleigh currently underway to verify system performance and ensure network integrity.

Preparation is progressing at the Mylestom and Norco Sewer Pump Station sites with site fencing, offices, water and power connections, and delivery of construction equipment are now in progress.

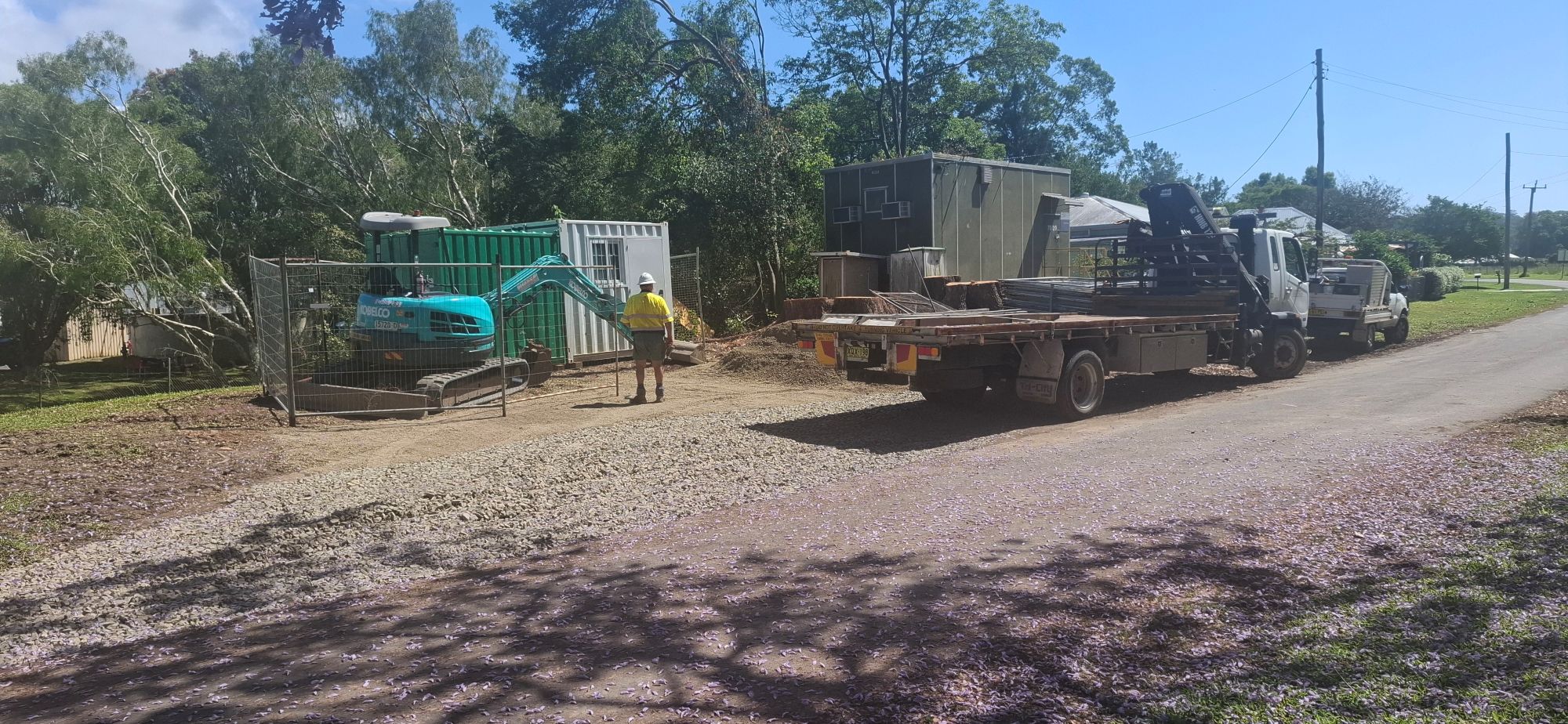

Raleigh Norco site compound.jpg

Image: Set up of the Raleigh Norco site compound

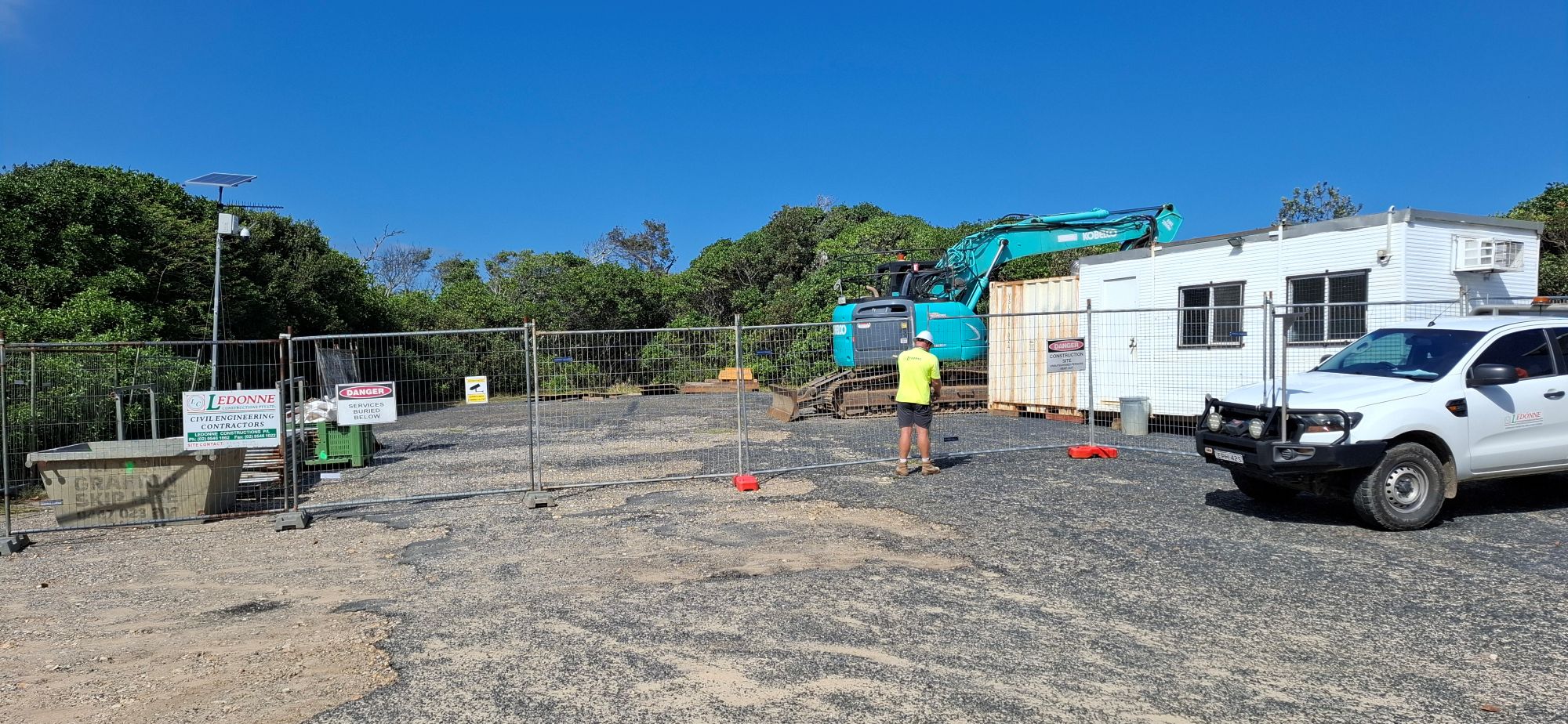

Mylestom Site compound.jpg

Image: Set up of the Mylestom site compound

Major upgrades are progressing at the existing Yellow Rock Sewer Pump Station to enable it to receive flows from Mylestom and Raleigh when both systems come online. Recent shutdown of the pump station was completed to allow for new switchboard to be installed.

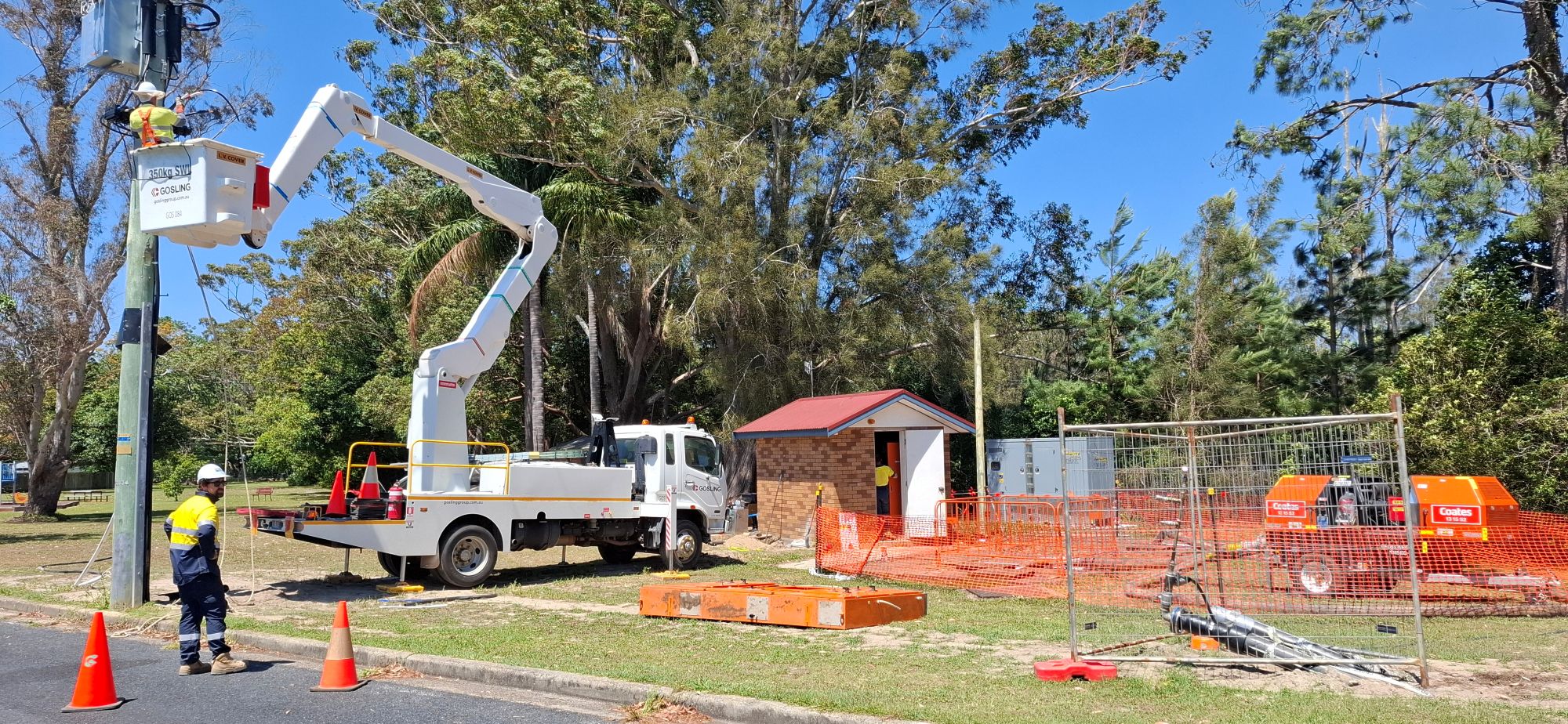

Yellow Rock SPS upgrade.jpg

Image: Bellingen Shire Council staff and contractors preparing the Yellow Rock Road sewer pump station for a switchboard replacement

Installation of sewer reticulation mains has been completed in Raleigh with works commencing in Mylestom, and just over 55% of the pipes installed (3,042m of 5,478m installed).

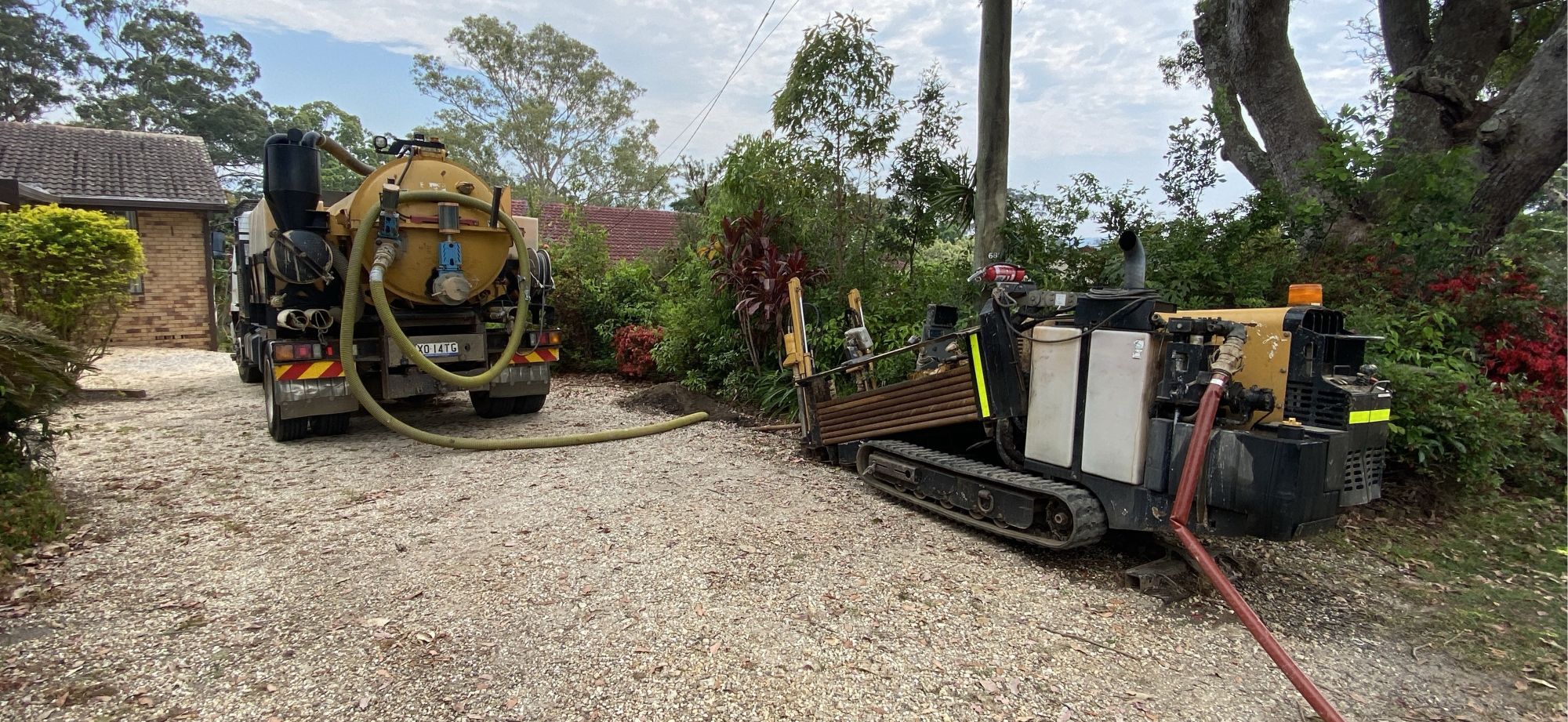

Installation sewer mains.jpg

Image: Installation of Sewer Mains through Mylestom and Raleigh by Directional Drilling

The first pressure sewer units have also been installed in Raleigh, with six units and drainage upgrades completed out of 226. Over the next few weeks, contractors will be continuing the installation of pressure sewer units at domestic properties in Raleigh. The project will then move to Yellow Rock, and into Mylestom by the end of the year, with final completion of all properties expected before October 2026.

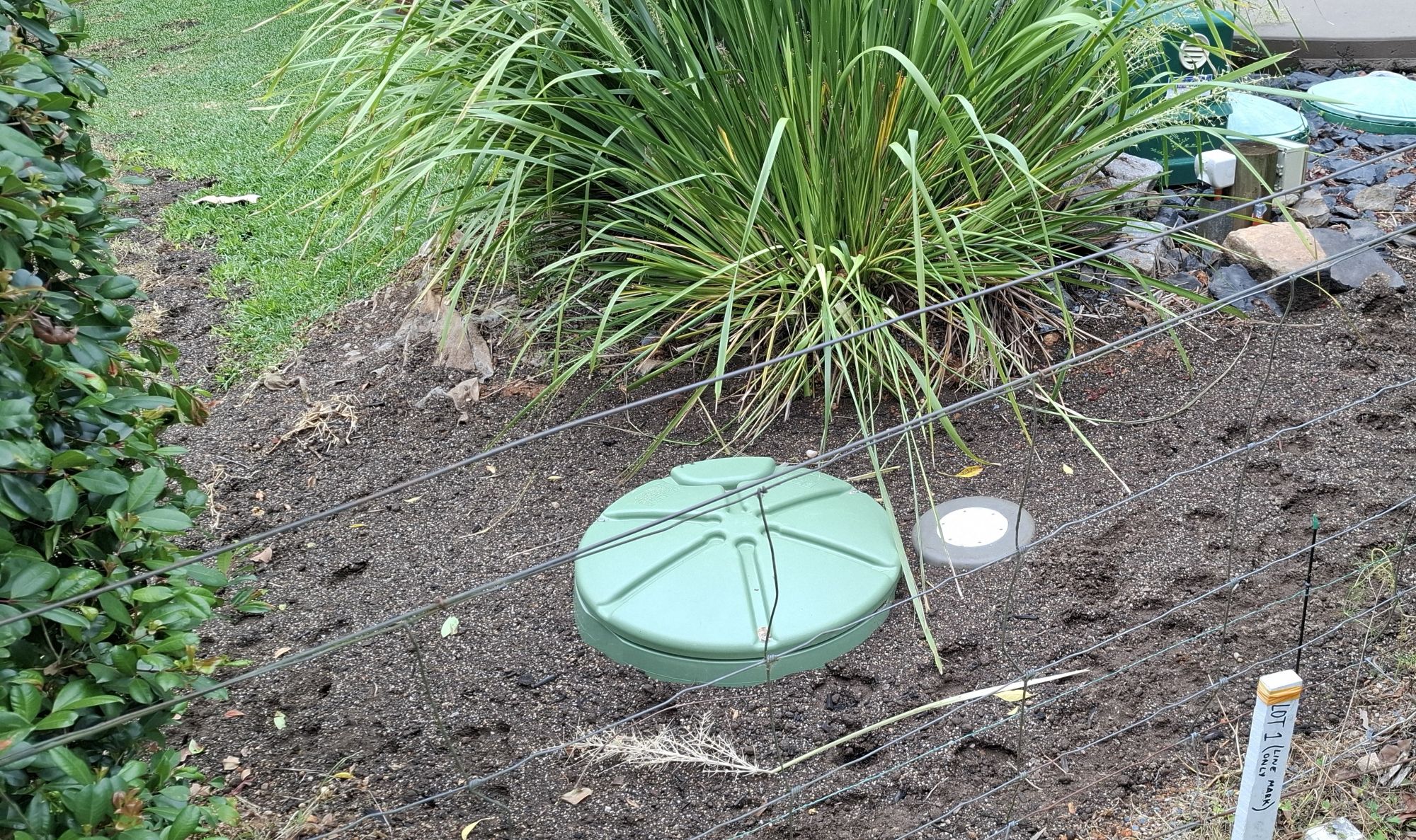

installed pressure sewer unit.jpg

Image: Installation of one of the first pressure sewer units for the project

Council appreciates the patience and cooperation of residents and businesses in the Raleigh and Mylestom areas as we undertake these works.
